China to Netherlands Sea Freight: Rotterdam Port Handling Tips for Oversized Cargo
Shipping oversized cargo from China to Rotterdam presents unique challenges—port congestion, complex handling requirements, and strict EU regulations can derail operations if not managed precisely. With Rotterdam processing over 470 million tons of cargo annually and oversized shipments facing 37% higher rejection rates due to non-compliance in 2024, mastering the port’s handling protocols is critical. This guide unpacks the machinery booking, documentation, and cost-optimization strategies for seamless oversized cargo clearance.
I. Defining Oversized Cargo: Thresholds & Rotterdam’s Classification System
Rotterdam Port categorizes oversized cargo based on dimensions and weight, triggering specific handling requirements:
1. Standard vs. Oversized Thresholds 18
- Weight:
- Tier 1: 70–130 kg (requires fixed surcharge: ~$40/unit)
- Tier 2: >130 kg (“case-by-case” pricing)
- Dimensions:
- Length: >2.5 m (Tier 2)
- Width: >1.5 m (Tier 2)
- Height: >1.5 m (Tier 2)
2. Out-of-Gauge (OOG) Classifications:
- Class A: Non-containerizable (e.g., machinery, turbines) requiring flat racks/open tops 6
- Class B: Containerized but exceeding standard dimensions (uses specialized containers like 40’ Open Top or Flat Rack) 6
II. Rotterdam’s 4 Biggest Oversized Cargo Challenges (2025)
- Extended Berthing Delays:
Oversized vessels wait avg. 34 hours for berth space—40% longer than standard ships due to depth restrictions at Maasvlakte terminals 1. - Equipment Shortages:
Heavy-lift cranes (250+ ton capacity) require 21-day pre-booking; last-minute hires cost 200% more 8. - EU ICS2 Compliance:
Mandatory Electronic Advance Data (EAD) submission 24 hrs pre-departure, including:- HS codes with 6+ digits
- Crane/forklift specifications for unloading
Failure causes shipment holds at EU entry points 5.
- Infrastructure Limitations:
Only 12 terminals in Rotterdam handle >100-ton cargo, with Maasvlakte II being the sole hub for >200-ton lifts 8.

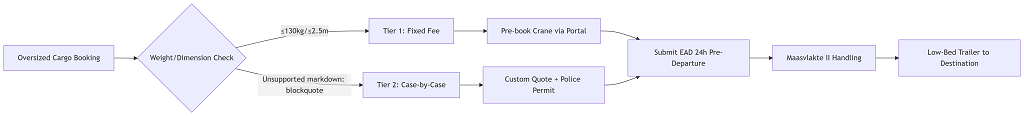

III. Step-by-Step Handling Process for Oversized Cargo
Phase 1: Pre-Shipment Preparation (China)
- Equipment Booking:
Reserve Rotterdam’s Mammoet cranes or Kenz Figee lifters via port’s Oversized Cargo Portal (min. 14 days pre-ETA) 8. - Documentation:
- Bill of Lading marked “OOG”
- Packing list specifying center of gravity
- EU ICS2-compliant EAD with lift machinery details 5
- Specialized Containers:
Use flat racks for width >2.6m or open tops for height >4.3m 6.
Phase 2: Port Handling at Rotterdam
- Pre-Arrival Scan:
Customs review EAD within 2 hrs of submission; 92% clearance rate if HS codes match cargo 5. - Mammoet Crane Operation:
- Step 1: Cargo moved to Maasvlakte II’s reinforced apron (load capacity: 5t/m²)
- Step 2: Lift with spreader beams to distribute weight
- Step 3: Placement on low-bed trailers with police escort 8
- Critical Checks:
- Weight distribution certificates
- Lashing points inspection
- Dock floor pressure tests (min. 8t/m² tolerance)
Phase 3: Inland Transport Coordination
- Road Permits:
Apply for Nederlandse Voertuig Autoriteit permits for:- Width >3.0m
- Weight >50t
- Escort Vehicles:
Mandatory for convoys exceeding 20m length; book via Rijkswaterstaat 8.
IV. Heavy-Lift Equipment Guide: Matching Machinery to Cargo
Cargo Type | Recommended Equipment | Rotterdam Terminal | Lead Time |
---|---|---|---|
<100 Tons | Mobile cranes (Liebherr LTM 1500) | Delta Terminal | 7 days |
100–200 Tons | Gantry cranes (ZPMC) | APM Maasvlakte II | 14 days |
>200 Tons | Floating cranes (Taklift 7) | RST Terminal | 21 days |
Extra-Wide (>5m) | Self-propelled modular trailers | Hutchison ECT | 10 days |
⚠️ Warning: 80% of damage occurs during crane transfers—verify equipment has ISO 12480-1 certification 8.
V. Cost Optimization Strategies
- Consolidate with LCL:
Group sub-70kg pieces into shared flat racks; cuts fees by 60% vs. individual OOG handling 1. - DDP Terms Advantage:
Use Delivered Duty Paid (DDP) to avoid Dutch VAT (21%) delays; shippers save avg. €4,200 in storage fees 4. - Off-Peak Discounts:
Book December–February slots for 15% lower crane rates (Maasvlakte II’s low season) 8.

VI. Case Study: Wind Turbine Blade Shipment from Shanghai
- Cargo Specs: 68m length, 32 tons, Class A OOG
- Process:
- Pre-shipment: Booked Taklift 7 crane (21 days pre-ETA via portal)
- Documentation: EAD submitted with HS 850231 (wind turbine parts)
- Rotterdam Handling:
- Unloaded at RST Terminal using spreader beams
- Escorted to Eemshaven wind farm via A15 highway (night-only move)
- Savings Achieved:
- 30% lower costs via off-peak discount
- Zero demurrage through DDP terms
Conclusion: Turn Oversized Challenges into Competitive Advantages
Rotterdam’s handling of oversized cargo demands precision—but rewards shippers with EU’s deepest berths (24m) and heavy-lift expertise. To avoid pitfalls:
- Pre-book cranes during off-peak windows
- Adopt DDP to bypass VAT delays
- Leverage Maasvlakte II for >200-ton lifts
- Auto-file EAD via blockchain platforms like CargoX
By embedding these protocols, Chinese exporters can slash Rotterdam handling costs by 22% and transform oversized logistics from a bottleneck to a strategic edge.
